The actions within this strategy are divided into two categories:
Action we will DOActions we will SUPPORTAction we will do are followed by “DO” and are colored in dark gray, and actions we will support are followed by “SUPPORT” and are colored in light gray.

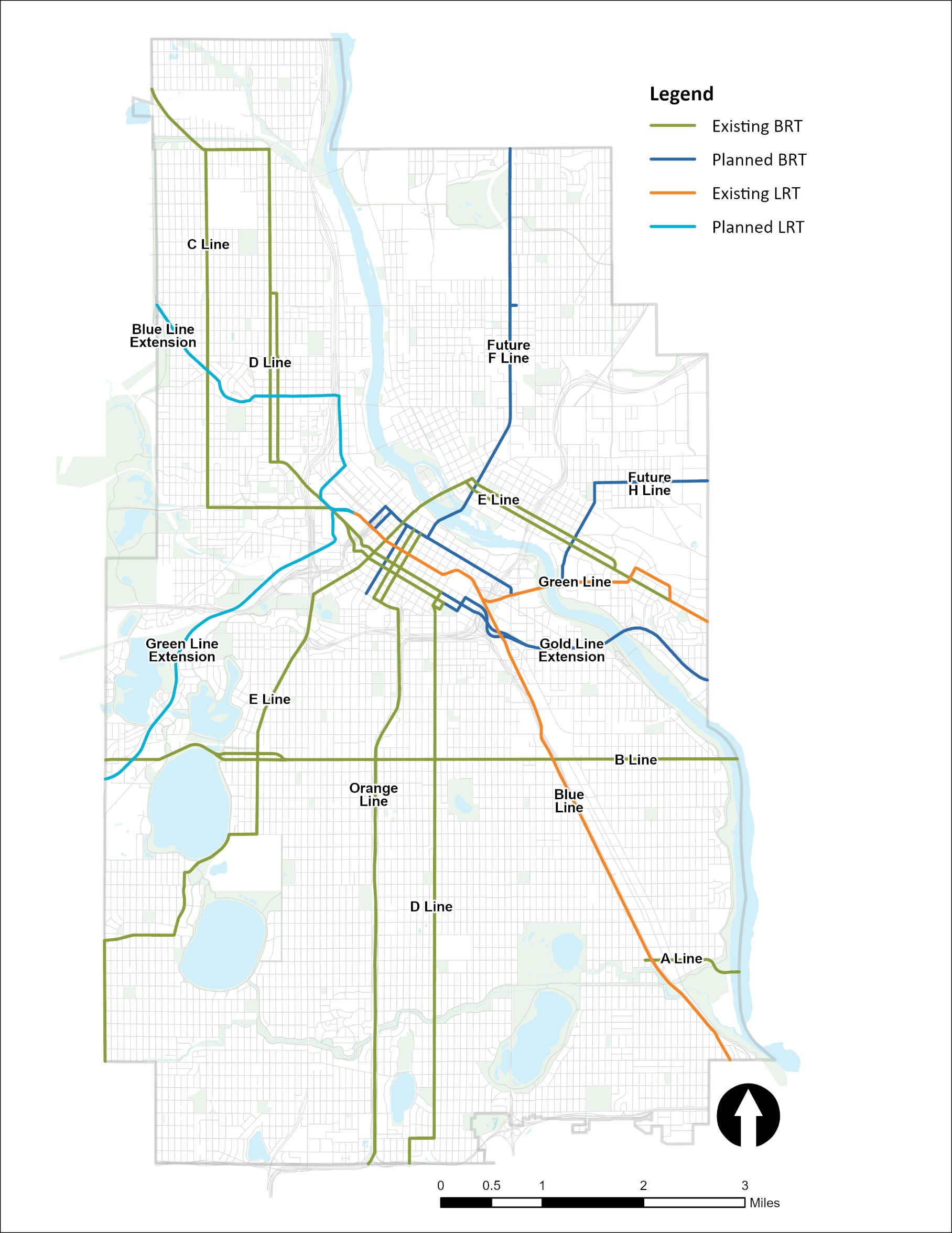

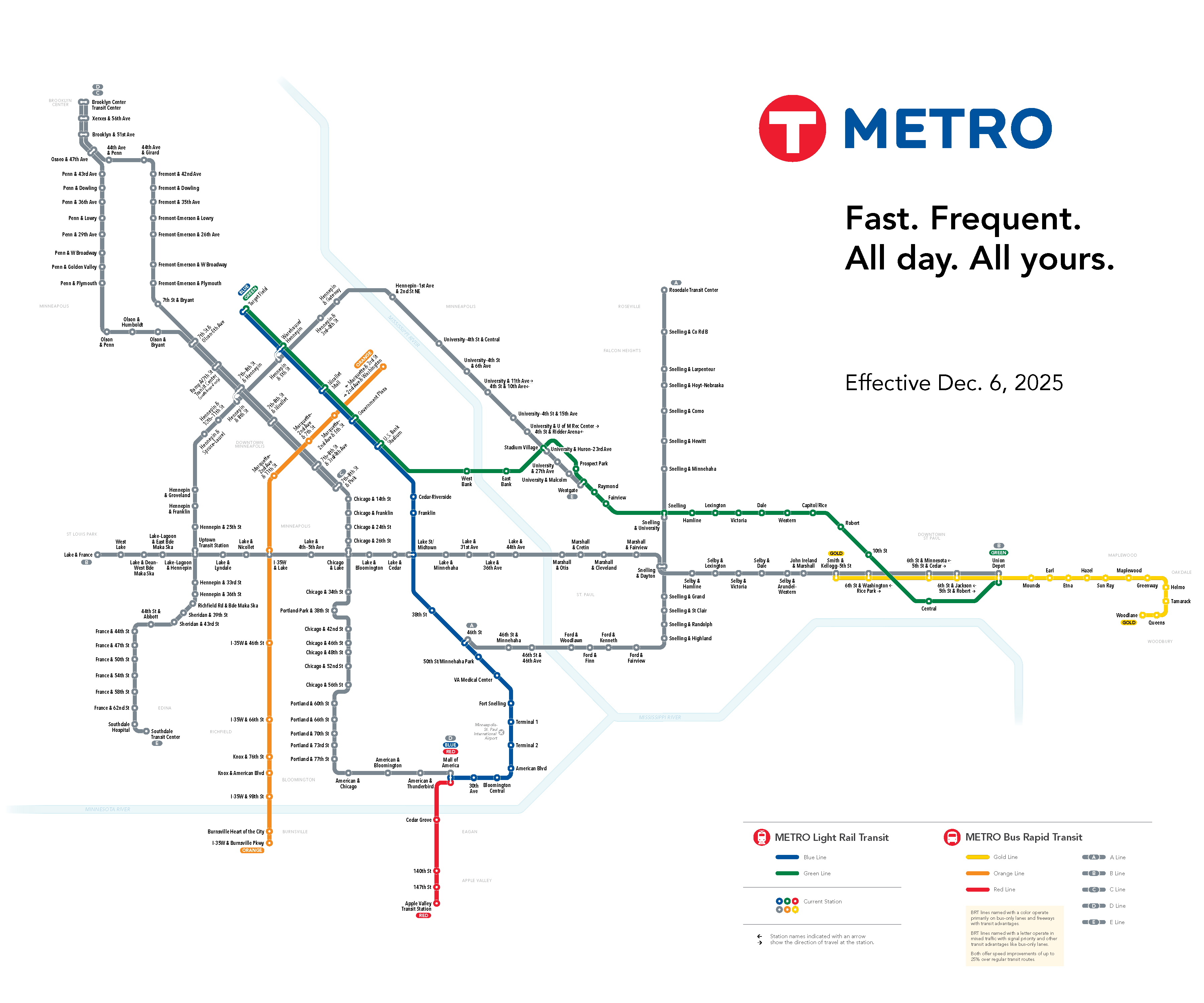

Learn more about how we get thereLight rail and bus rapid transit routes provide the major spines of the existing METRO transitway system in Minneapolis, along with one commuter rail line. Bus rapid transit service includes off-board fare payment, fewer stops compared to regular transit lines, enhanced shelters that include real-time vehicle information, and longer buses that allow for all-door boarding. Light rail service is similar but runs along dedicated rail lines. The existing light rail has routinely exceeded ridership expectations and has spurred development along the corridors. High frequency transit serves about 3% of the region by land area, but the volume of development it is capturing is significant.1
Light rail and bus rapid transit are major capital investments; however, bus rapid transit projects are less costly to build and quicker to plan and construct than light rail projects, which require a larger scale of investment and time needed for implementation. Fifty percent of the funding for design and construction of light rail and bus rapid transit projects is historically provided by the federal government. We believe that expanding the METRO transitway network is an effort worth investing in. It will be critical with any new light rail developments in Minneapolis that provisions are in place to ensure that nearby residents benefit from the transit investment, including through preservation and construction of affordable housing.
Several projects in Minneapolis have gone through early environmental review processes and have a locally preferred alternative identified. The extents of these corridors are extended below in cases, reflecting the vision of increasing high frequency transit to more people throughout the city.
Plan, design and construct high capacity, neighborhood-based transit along the Nicollet-Central corridor.
Climate Prosperity Mobility Active Partnerships
High
2028-2030 (Years 8-10)
Successfully completed to date and on-going
Significant milestone(s): Public Works has supported with the F Line feasibility study and advocacy efforts at the state legislature to provide mode flexibility along the corridor. Construction is currently expected to begin in 2028. The New Nicollet project will reconnect Nicollet Ave between Lake St and 29th St and allow for transit service on Nicollet Ave. Public Works has supported Metro Transit with the 2025 Arterial Bus Rapid Transit study update, which is evaluating the Nicollet Ave corridor as a potential future Bus Rapid Transit line.
Plan, design and construct high capacity, neighborhood-based transit within the dedicated right of way along the Midtown Greenway from West Lake Station on the METRO Green Line Extension to Lake Street Station on the METRO Blue Line.
Climate Prosperity Mobility Active Partnerships
High
2030+ (Years 10+)
Not Started
Metro Transit, in partnership with Hennepin County and Minneapolis Public Works opened the B Line bus rapid transit route in 2025 and continues to support Hennepin County's efforts to preserve space and plan for future transit service within the Midtown Greenway.
Plan, design and construct high capacity, neighborhood-based transit along the West Broadway corridor from downtown Minneapolis to the northwest suburbs.
Climate Prosperity Mobility Active Partnerships
High
2028-2030 (Years 8-10)
In Progress
The Blue Line Extension Light Rail project has been in planning phases for over a decade, and final design will take place in 2025-2026. The City has actively participated in this process.
Advocate and provide continued support for METRO B, D, and E Bus Rapid Transit lines, and work with Metro Transit to identify and pursue additional Bus Rapid Transit Lines in Minneapolis.
Climate Equity Prosperity Mobility Active Partnerships
Low
2020-2023 (Years 0-3)
Successfully completed to date and on-going
Minneapolis supports Bus Rapid Transit lines and dedicates resources to assist with planning, design, construction, and operation phases.
Advocate and provide continued support for the METRO Blue Line Extension light rail project, connecting Minneapolis with the region’s northwestern communities. As the transit service is reevaluated, ensure new routing alignments provide high-quality service for residents of North Minneapolis and safety improvements are made to the prior alignment along Olson Memorial Highway, bringing reduced speeds and more people-focused and urban scale improvements to the corridor.
Climate Prosperity Mobility Active Partnerships
High
2020-2023 (Years 0-3)
Successfully completed to date and on-going
The City continues to support Blue Line Extension project work. The City supports safety improvements to Olson Memorial Highway by supporting agencies completing a feasibility study of bus rapid transit for the corridor and a related study of the corridor to identify long-term design alternatives.
Support bus rapid transit on Olson Memorial Highway (Highway 55) extending to the region’s western communities.
Climate Prosperity Mobility Active Partnerships
Low
2020-2023 (Years 0-3)
Successfully completed to date and on-going
Public Works is supporting Metro Transit and Hennepin County in their evaluation of Bus Rapid Transit on Olson Memorial Highway (OMH) to the metro’s western communities. The OMH BRT study resumed in 2025.
Develop long-term operations plans for new transit services in partnership with Metro Transit and other partner agencies.
Climate Mobility Active Partnerships
Medium
2024-2027 (Years 4-7)
Successfully completed to date and on-going
Metro Transit's Network Now has been endorsed by the Met Council and will be implemented through quarterly service changes.
Advocate for light rail and bus rapid transitways that provide direct connections to regional job centers and other destinations outside of the downtown core within Minneapolis, connecting Minneapolis residents with the regional rail system.
Climate Mobility Active Partnerships
High
2020-2023 (Years 0-3)
Successfully completed to date and on-going
The City actively coordinates with Metro Transit on light rail and bus rapid transit projects connecting Minneapolis residents to the greater region. The City granted municipal consent for the Blue Line Extension in fall 2024.
Advocate for transitway alignments that are conducive to transit-oriented development and that would include preservation, maintenance and construction of housing at all levels of affordability.
Climate Equity Prosperity Mobility Active Partnerships
Medium
2020-2023 (Years 0-3)
Successfully completed to date and on-going
Minneapolis, along with other cities along the Blue Line Extension corridor, is actively working on anti-displacement efforts to ensure this project has minimal displacement effects.
Continue to partner with the Hennepin County Regional Railroad Authority, Metro Transit, the Minnesota Department of Transportation, and developers near Target Field Station to plan for the expansion of future commuter rail, inter-city passenger rail, and/or high-speed rail projects and supporting facilities.
Climate Equity Prosperity Mobility Active Partnerships
High
2020-2023 (Years 0-3)
Successfully completed to date and on-going
Public Works has supported with the F Line feasibility study and advocacy efforts at the state legislature to provide mode flexibility along the corridor. Construction is currently expected to begin in 2028. The New Nicollet project will reconnect Nicollet Ave between Lake St and 29th St and allow for transit service on Nicollet Ave. Public Works has supported Metro Transit with the 2025 Arterial Bus Rapid Transit study update, which is evaluating the Nicollet Ave corridor as a potential future Bus Rapid Transit line.
Support statewide efforts to advance the Northern Lights Express (NLX) connecting Minneapolis with Duluth via high speed rail.
Prosperity Mobility Active Partnerships
Medium
2030+ (Years 10+)
Successfully completed to date and on-going
The City will monitor for changes at the state legislature and continue to support efforts to advance this project.
